Weekly Construction Update - Friday, September 19, 2025

DATE: Friday, September 19, 2025

SPECIAL ANNOUNCEMENT: The Exit 16 DDI Project will be conducting drilling and blasting activities (blasting) to remove hard rock and ledge below the surface of the ground that cannot be removed using mechanical methods. Blasting is anticipated to begin the week of October 6. The start of blasting activities is dependent on both weather and the contractor's schedule. Blasting will take place along U.S. Route 2/7 (U.S. 2/7) within the project limits. Up to two blasting events will take place a day and will be restricted to weekdays and daytime hours. Additional information will be provided in the coming weeks. For additional information, click here to learn more.

TRAFFIC IMPACT AND DURATION: From Sunday, September 21, through Friday, September 26, between the hours of 7 PM and 6 AM, crews will be working on U.S. 2/7 near the Whitcomb Street under lane closures and lane reductions. One lane will be maintained in each direction along U.S. 2/7 under traffic shifts. The entrance to Whitcomb Street will be closed during nighttime hours (7 PM – 6 AM), reopening each morning.

From Monday, September 22, through Friday, September 26, between 6 AM and 3 PM, crews will be working along U.S. 2/7 between Lower Mountain View Drive and the Interstate 89 (I-89) southbound on and off ramps under lane closures and lane reductions. Lane shifts on Lower Mountain View Drive will be in effect with traffic maintained.

Motorists should expect significant delays when traveling through the work zone and along adjacent roadways. Please plan ahead, leaving plenty of additional time to get to and from your destination. Whenever possible, consider alternate routes or other forms of transportation such as carpooling, ridesharing, transit, biking, or walking. Drivers should slow down, use caution, and follow flaggers and road signs.

CONSTRUCTION ACTIVITIES: During the nighttime hours, crews will be installing drainage infrastructure along U.S. 2/7 near Whitcomb Street. During the daytime hours, crews will be installing drainage infrastructure along U.S. 2/7, starting at Lower Mountain View Drive and continuing south towards the I-89 southbound ramps and performing clearing operations in preparation for blasting activities starting in early October.

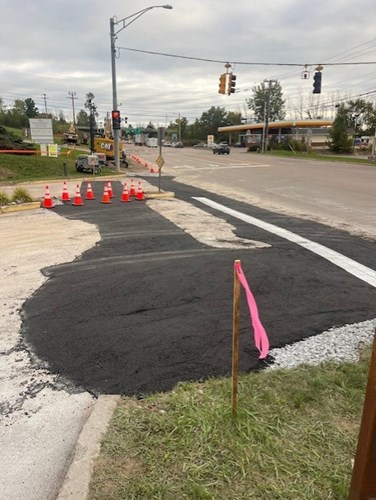

View from the Highpoint Center driveway

Click here for the full Construction Update

Nearby Construction Project Highlights:

Colchester Exit 17 Project

  • Project Area: I-89 Exit 17, U.S. 7 between the Shell Gas Station and Wiley Road, U.S. 2 between Chimney Corner and Jasper Mine Road
  • Next week: Crews will pave the Exit 17 deceleration lane and I-89 northbound and southbound near Exit 17, install traffic signals on U.S. 2, and excavate along U.S. 7.
  • Traffic Impacts: Monday – Friday, 6 AM – 7 PM | I-89 northbound and southbound single-lane closures near Exit 17 during off-peak hours. U.S. 2 lane closures and intermittent alternating one-way traffic. Traffic shifts along U.S. 7.
  • Construction: Spring 2024 - Summer 2026
  • Project Website

City of Winooski Project – Main Street Revitalization

  • Project Area: Main Street in Winooski, between the railroad bridge near Maple Street and the Colchester town line near Checkerbay Carwash
  • Next week: Crews will continue with traffic signal and streetlight work, brick paver installation, road reconstruction including curb installation, underground utility and stormwater work, and driveway paving.
  • Traffic Impacts: Monday – Friday, 7 AM to 7 PM | Main Street restricted to northbound traffic only; Southbound traffic detoured to Tigan Street and Weaver Street. Periodic side street closures at Main Street intersections.
  • Construction: Spring 2024 – Summer 2026
